Construction control for owner-builders

Veridom

Building phases and critical checkpoints, so inspections happen before an irreversible stage is closed. Contractors upload evidence and sign off milestones in their own area.

Role
Product, design and build — end to end, with AI
Made with
Built with Claude and Lovable

01Context

Veridom gives the owner a phase-by-phase control structure and puts the contractors inside it, so evidence exists at the moment it still matters.

02The problem

On a private build, the expensive mistakes are the ones you can no longer see: a checkpoint missed before concrete is poured, insulation closed up before anyone looked.

03What was built

  • 01Building phases with critical checkpoints that must clear before the next irreversible stage.
  • 02Contractor access scoped to their own areas of the project.
  • 03Photo and document evidence uploaded against each checkpoint.
  • 04Milestone sign-off with an audit trail.
  • 05Multi-country rule sets: Austria, Ukraine, Poland and California.

04Automation

How the flow runs — input, AI, the human decision point, and what comes out.

01Phase reaches checkpointcountry rule set applied
AIChecklist + evidence checkflags what is missing
HUMANOwner or inspector signs offbefore the stage closes
04Locked record, next phase opensaudit trail kept
Fig. 01 — Checkpoint gating before irreversible stages

05Stack

  • Claude
  • Lovable
  • React / TypeScript
  • Postgres with row-level access rules
  • File storage
  • Role-based permissions

06Numbers

Country rule sets
4 — Austria, Ukraine, Poland, California
Projects managed
[add number]

Editable placeholder

Checkpoints tracked per build
[add number]

Editable placeholder

Rework or cost avoided
[add figure]

Editable placeholder

07Screens

From the live app.

veridom.space

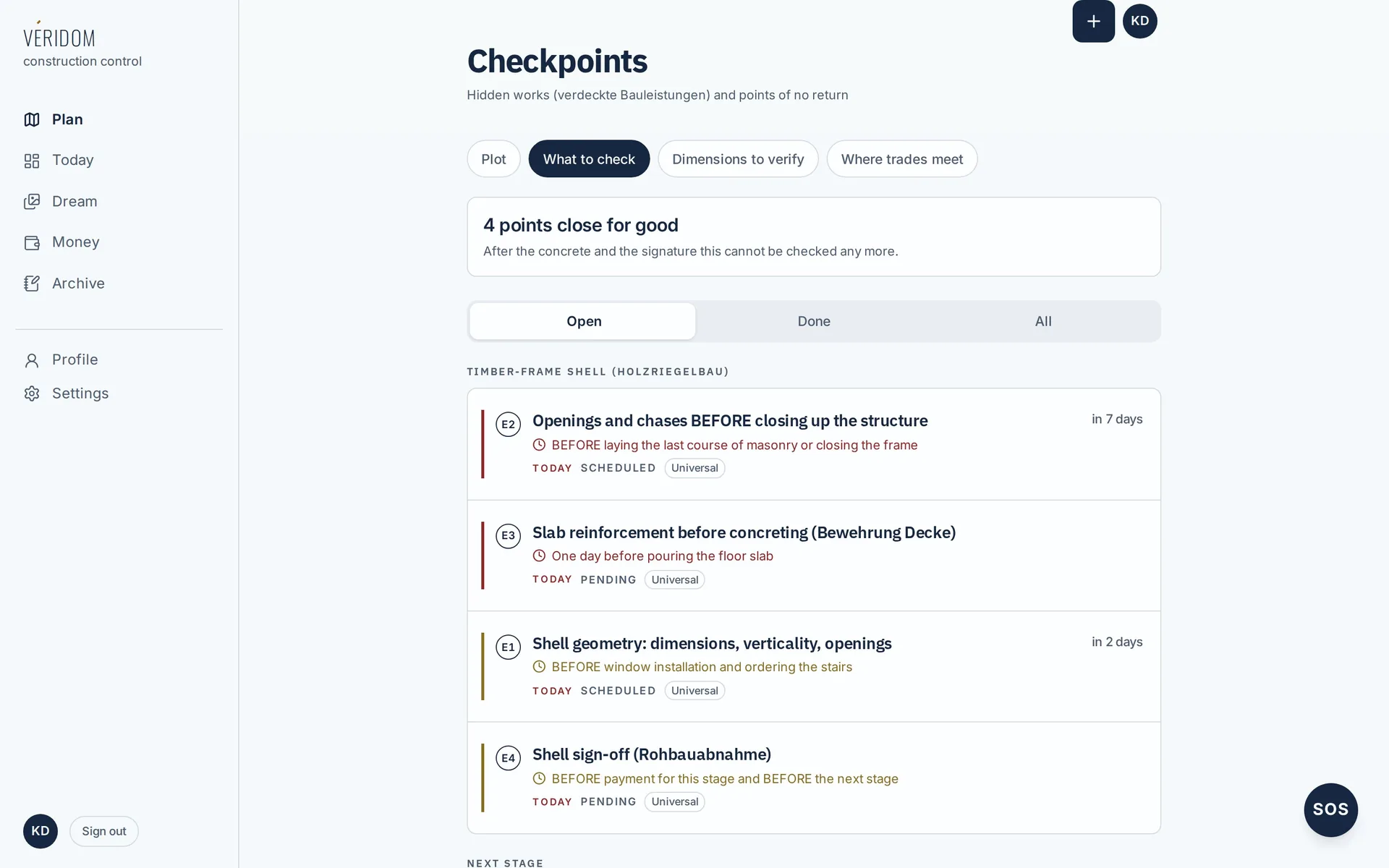

Veridom Checkpoints page on desktop for the demo project, headed "4 points close for good — after the concrete and the signature this cannot be checked any more", listing hidden works like openings before closing the structure and slab reinforcement before concreting.
Checkpoints: what must be inspected before it's covered for good
Veridom Today screen on a phone: stage 5 of 14, timber-frame shell, a card reading "7 that will not wait" and an SOS button for on-site change proposals.

Today: only what won't wait

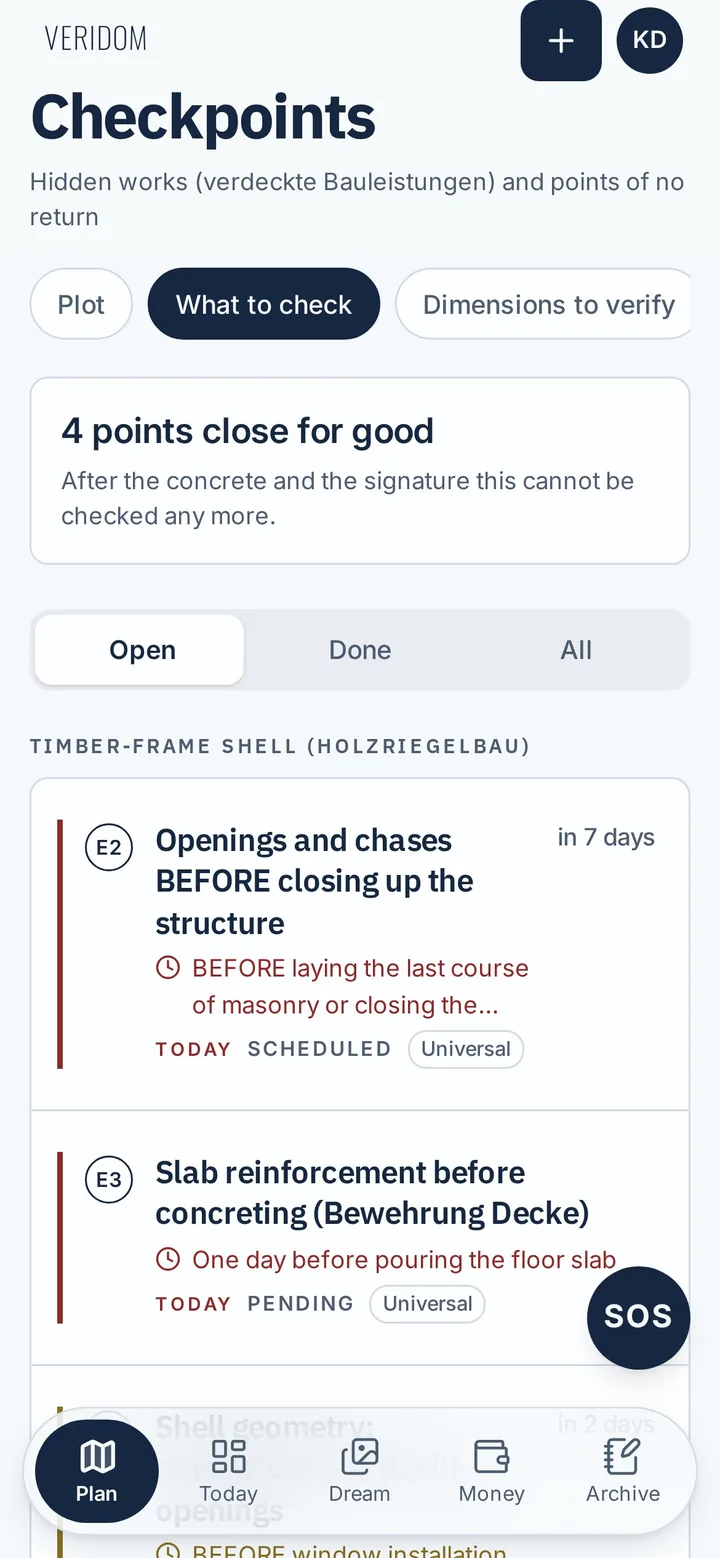

Veridom Checkpoints screen on a phone: "4 points close for good" and a list of open checkpoints such as slab reinforcement before concreting.

Checkpoints, on site

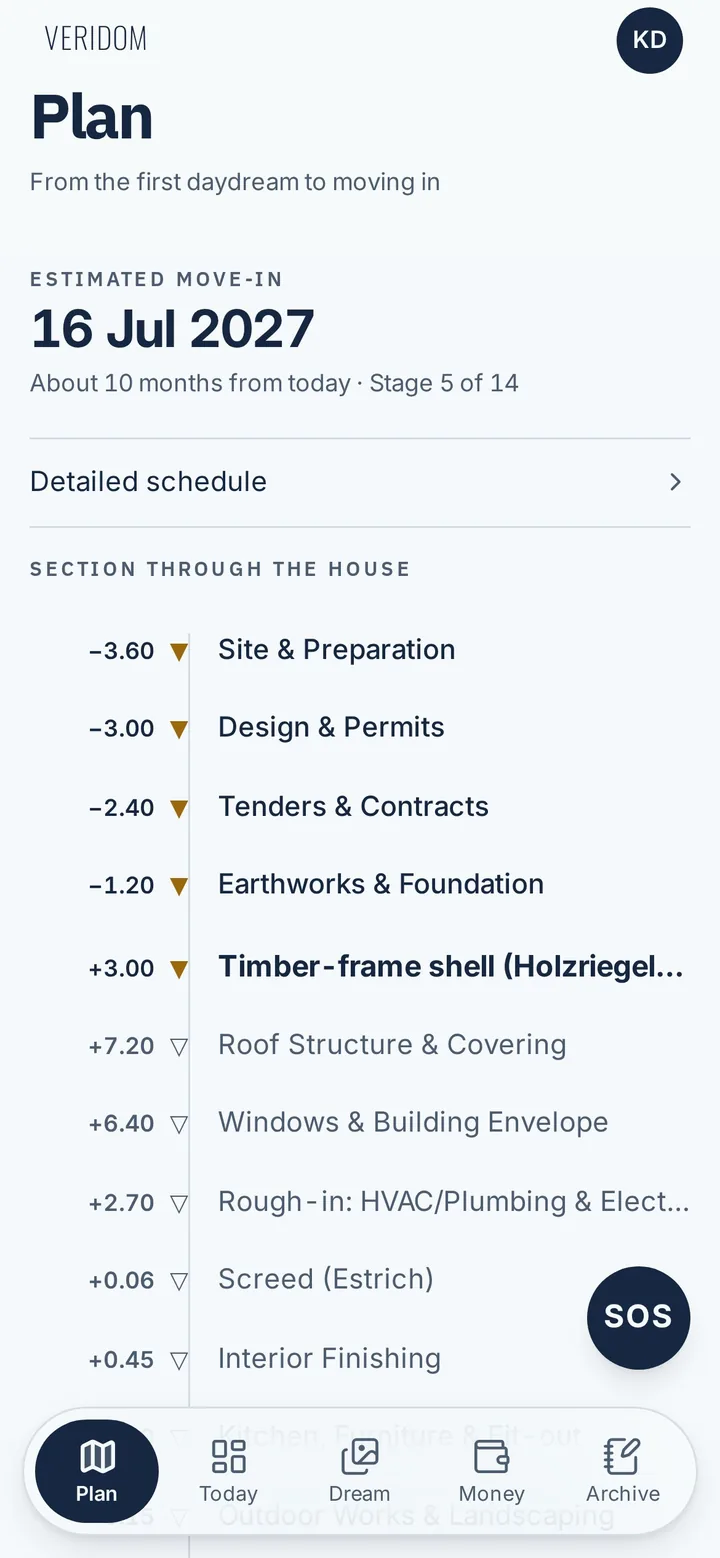

Veridom Plan screen on a phone: estimated move-in 16 July 2027 and the building stages drawn as levels of a house section, from −3.60 site preparation upwards.

Plan: the house as a section, from −3.60 to move-in

veridom.space

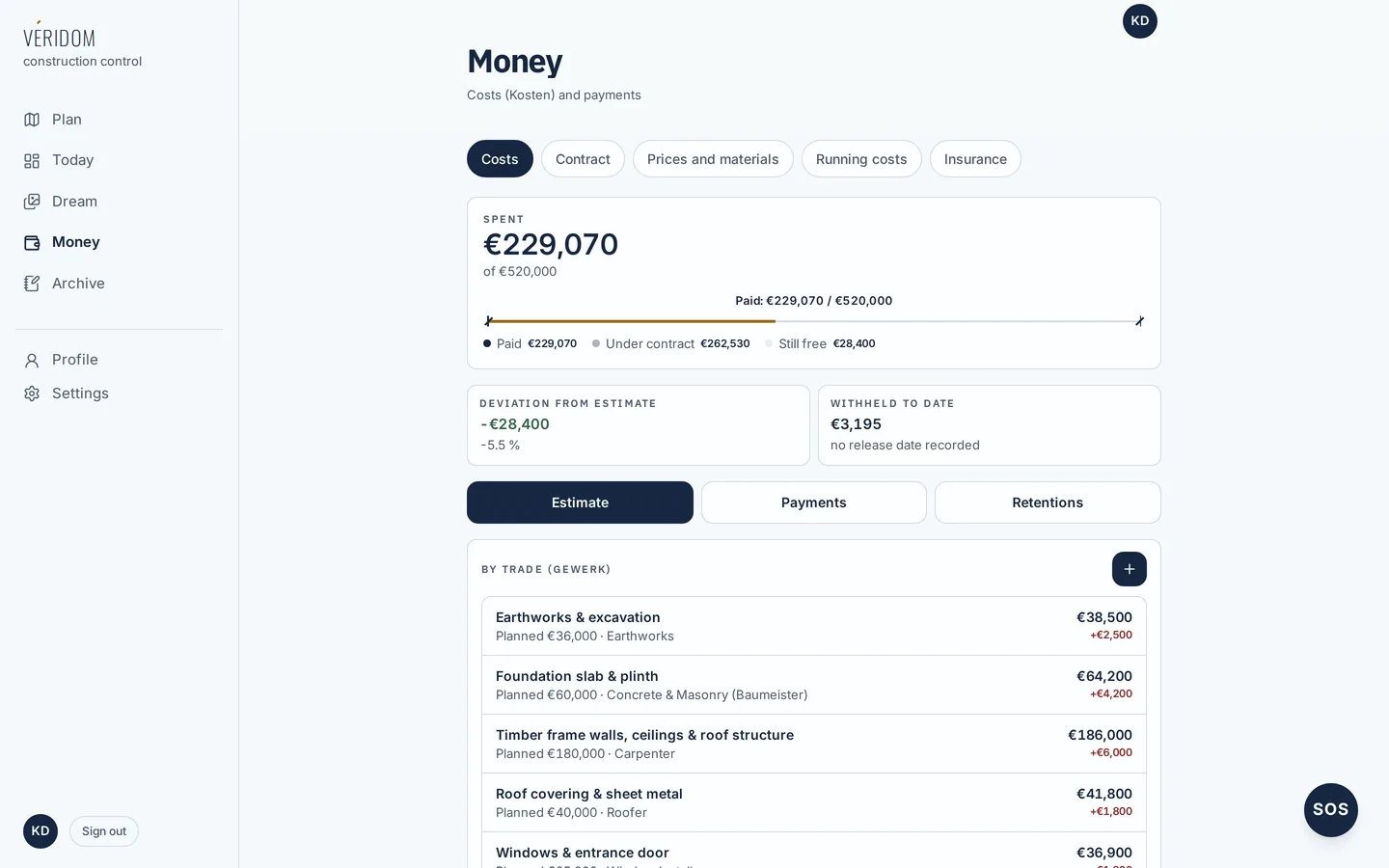

Veridom Money page on desktop: €229,070 spent of a €520,000 budget, deviation from estimate, withheld amounts, and costs by trade with planned versus actual figures.
Money: estimate vs. actual per trade
veridom.space

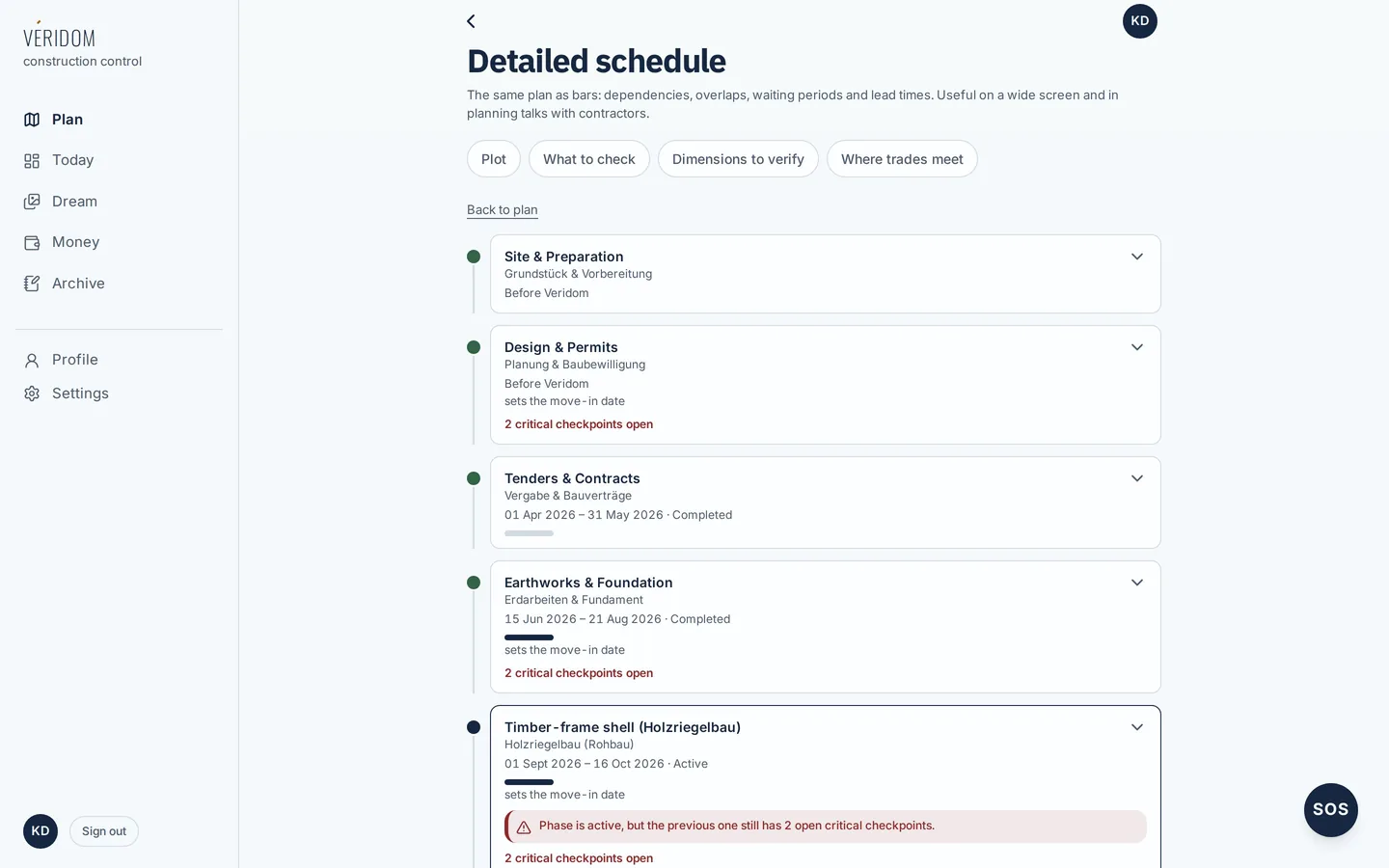

Veridom Detailed schedule on desktop: building phases as a timeline with dates and status, and a warning that the active phase still has two open critical checkpoints from the previous one.
Schedule: dependencies and critical checkpoints
